The Downtime Debt Nobody Talks About
Unplanned downtime is not just a maintenance issue - it is a financial leak that silently reduces production capacity, margin, customer commitments, and asset reliability. For industrial manufacturers, every unexpected equipment failure can convert directly into lost output, emergency repair cost, overtime labour, quality risk, and delayed delivery. A predictive maintenance ROI calculator helps leaders move beyond assumptions and quantify the real business value of early failure detection, condition monitoring, and planned intervention.

- - $260,000 / Hour: Downtime CostUnplanned equipment downtime can cost manufacturers hundreds of thousands of dollars for every lost production hour.
- - 30–50%: Downtime ReductionPredictive maintenance helps reduce unexpected failures by detecting issues before they stop production
- - 20–40%: Asset Life ExtensionCondition-based maintenance improves asset reliability and extends equipment life by preventing severe damage.
- - 8–12%:Maintenance Cost SavingsPredictive maintenance lowers maintenance spend by reducing emergency repairs, unnecessary servicing, and spare-part waste.
The frustrating part is that most organisations already suspect predictive maintenance (PdM) would help. The sensors exist. The AI platforms exist. The case studies exist. What is often missing is a clear, defensible answer to the question that every CFO, operations director, or plant manager will ask before signing off on any new investment: What is the return on investment? And when do we see it?
This article exists to answer that question precisely. We break down the eight key inputs that determine your PdM ROI, walk through a fully worked calculation example, explain each output metric in plain language, and give you the framework to identify which assets should be prioritised in a pilot programme. Whether you are building a business case for a board presentation or simply stress-testing a vendor's ROI claim, this is the reference you need.
If you are tasked with driving efficiency, reducing downtime, and scaling technology in heavy industry, yes. This guide is specifically crafted for:
• The Decision Makers: Plant Managers & Operations VPs
• The Execution Leaders: Maintenance Directors
• The Innovators: Digital Transformation Leaders
Applicable Industries: Manufacturing | Oil & Gas | Utilities | Food & Beverage | Water & Process Industries
What Is Predictive Maintenance and Why Does ROI Matter?
Predictive maintenance is the practice of using real-time sensor data, historical failure records, and AI/ML models to forecast equipment failures before they occur, enabling maintenance to be performed at the optimal moment: after clear early warning signs appear but before failure strikes.
It sits at the top of the maintenance maturity ladder, above reactive maintenance (fix it when it breaks), preventive maintenance (service it on a calendar schedule), and condition-based maintenance (act when a parameter crosses a threshold). The critical distinction is that PdM uses predictive modelling to anticipate degradation, not just observe it.
| Strategy | Trigger | Avg Downtime | Spare Part Waste | Typical Cost Ratio |
|---|---|---|---|---|
| Reactive | Failure occurs | High (unplanned) | High (emergency) | Baseline = 1.0x |
| Preventive | Calendar schedule | Medium (planned) | Medium (over-maintenance) | 0.75–0.85x |
| Condition-Based | Threshold breach | Low–Medium | Medium-Low | 0.55–0.70x |
| Predictive | AI forecast | Very Low | Low (just-in-time) | 0.35–0.50x |
The ROI case for predictive maintenance is compelling precisely because savings are generated across multiple cost dimensions simultaneously: downtime avoidance, spare part optimisation, labour efficiency, extended asset life, and reduced energy waste. This multi-lever savings profile is what makes PdM investments typically deliver ROI between 200% and 400% in the first three years of deployment.
But ROI is highly site-specific. A facility with high-value equipment, frequent failures, and expensive downtime will see dramatically different returns than a plant with cheap machines and low production value. That is exactly why a structured calculation matters, and why generic vendor ROI claims are almost always wrong for your specific situation.
The PdM ROI Core Framework: The 8 Critical Inputs
The following eight variables form the complete input set for a rigorous PdM ROI calculation. Understanding each input, what it represents, how to gather it accurately, and what to watch for, is essential for producing a credible business case.

1. Asset & Operational Baseline
Input 1: Number of Machines
- - Definition: The exact scope of the PdM deployment—the total count of assets actively being monitored. While more machines increase sensor and platform costs, they exponentially scale aggregate savings potential.
- - Data Gathering Tip: Extract your asset register from your CMMS or ERP. For a pilot phase ROI, restrict this count strictly to the specific asset class being monitored (e.g., only compressors at Site A) rather than the full enterprise population to keep the business case defensible.
Input 3: Average Downtime Hours Per Month
- - Definition: The baseline duration of operational stoppages. This must capture both complete production halts and partial-capacity events, which are often invisible in headline metrics but massive in aggregate.
- - Data Gathering Tip: Pull a 12-month history from your CMMS to smooth out seasonal variations. If your system merges repair time with downtime, cross-reference shift logs, production reports, or manually timed historical incidents.
Input 6: Failure Frequency (Failures Per Month)
- - Definition: The total number of significant failures—those causing measurable downtime or production loss—across the monitored population.
- - Data Gathering Tip: Categorize failures into known causes (bearing wear, seal degradation, lubrication failure) vs. unknown causes. Focus your ROI projections primarily on the known causes, as these represent the predictable failure modes that sensors and AI models can actually learn to anticipate.
2. Financial Cost Stack
| Input Variable | What Full Cost Optimization Includes | The Hidden Traps & Industry Benchmarks |
|---|---|---|
| Input 2: Downtime Cost Per Hour (£ / $) | • Lost production revenue • Idle labor costs • Secondary equipment starvation • SLA/contractual penalties • Emergency response fees | The Trap: Relying only on lost production revenue understates true downtime costs by 30–60%. You must build a comprehensive cost stack for a credible business case. |
| Input 4: Maintenance Team Cost Per Month (£ / $) | • Fully loaded salaries & benefits • Overtime premiums • Contract labor • Shared service allocations | The Reality: PdM rarely reduces headcount. Instead, it reallocates time from reactive firefighting to planned work, allowing the same team to manage more assets or higher-value tasks. |
| Input 5: Spare Part Cost Per Month (£ / $) | • Emergency procurement premiums • Buffer stock carrying costs • Obsolescence write-offs • Urgent logistics charges | The Benchmark: Reactive operations carry 15–25% higher part costs. PdM enables Just-In-Time (JIT) procurement aligned to forecast failure windows, slashing inventory holding costs. |
3. Predictive Impact Projections
Input 7: Expected Downtime Reduction (%)
- - Definition: The percentage of current downtime that the PdM program is expected to eliminate via early warnings and scheduled interventions.
- - Strategy: While vendor best-case claims boast higher numbers, use a conservative 25–30% as your initial defensible baseline for the business case.
Input 8: Expected Asset Life Extension (%)
- - Definition: The extension of the operational life of capital assets achieved by catching degradation early and mitigating fatigue damage accumulation.
- - Strategy: For long-lived assets (30+ year design life), even a modest 10% extension defers millions in capital expenditure (CapEx), significantly boosting the long-term Net Present Value (NPV) of your PdM investment.

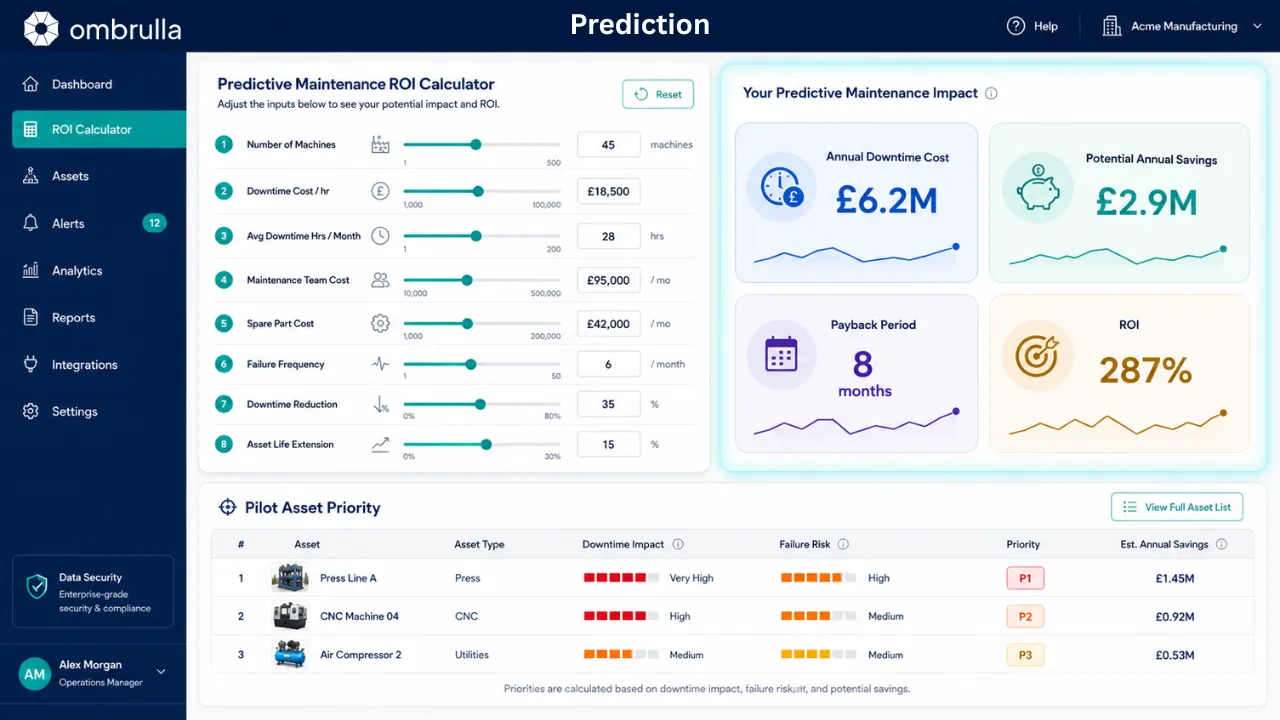

Worked Example: The ROI Calculator in Action
To make the calculator framework concrete, let us walk through a realistic worked example based on a mid-sized automotive components manufacturer operating three production shifts across 45 CNC machining centres and press lines.

Scenario: Apex Precision Components Ltd.
| Input Variable | Value Entered | Source |
|---|---|---|
| Number of machines | 45 assets | CMMS asset register |
| Downtime cost per hour | £18,500/hr | Finance + ops calculation |
| Average downtime hours per month | 28 hours | 12-month CMMS average |
| Maintenance team cost per month | £95,000/mo | HR payroll + contracts |
| Spare part cost per month | £42,000/mo | Procurement records |
| Failure frequency | 6 failures/month | Work order history |
| Expected downtime reduction | 35% | Conservative benchmark |
| Expected asset life extension | 15% | Equipment OEM data |
The 5 ROI Outputs Explained
Once the eight input variables are entered into the Predictive Maintenance ROI model, the calculator generates five business-critical outputs. Together, these outputs show whether PdM is financially justified, how quickly the investment pays back, and where the deployment should begin.
For the Apex Precision example, the results clearly show that predictive maintenance is not just a reliability initiative, it is a measurable financial recovery opportunity.
Output 1: Annual Downtime Cost
Formula: Downtime Cost per Hour × Average Downtime Hours per Month × 12
Calculation: £18,500 × 28 hours × 12 months = £6,216,000
| Metric | Value |
|---|---|
| Monthly Downtime Cost | £518,000 |
| Annual Downtime Cost | £6,216,000 |
| Current Status | Baseline before PdM |
This figure represents the current financial exposure created by unplanned equipment downtime. For Apex Precision, more than £6.2 million is lost every year due to equipment failures that are often predictable and preventable. This number becomes the financial anchor of the business case. It shows the maximum addressable opportunity and gives leadership a clear view of the cost of doing nothing.
Output 2: Potential Annual Savings
Formula: Annual Downtime Savings + Spare Parts Savings + Labour Efficiency Savings
| Savings Lever | Calculation | Annual Savings |
|---|---|---|
| Downtime Savings | £6.216M × 35% reduction | £2,175,600 |
| Spare Parts Savings | £42,000/month × 20% × 12 | £100,800 |
| Labour Efficiency | £95,000/month × 10% × 12 | £114,000 |
| Total Annual Savings | Combined savings across all levers | £2,390,400 |
The savings come from three independent value drivers:
- - Downtime avoidance is the largest contributor, driven by early fault detection and reduced unplanned stoppages.
- - Spare parts optimisation reduces emergency part consumption, overstocking, and unnecessary replacements.
- - Labour efficiency improves maintenance planning, reduces reactive work, and allows teams to focus on higher-value activities.
This multi-channel savings structure is important for CFO-level approval because the ROI is not dependent on one optimistic assumption. Even if one savings lever underperforms, the business case remains supported by other measurable gains.
Output 3: Payback Period
Formula: Total PdM Investment Cost ÷ Monthly Savings
For this scenario, the estimated investment for deploying PdM across 45 assets is: £1,350,000
This includes IIoT sensors, edge compute hardware, cloud AI platform costs, system integration, commissioning, and deployment support.
| Metric | Value |
|---|---|
| Total PdM Investment | £1,350,000 |
| Monthly Savings | £199,200 |
| Payback Period | 6.8 months |
| Break-Even Point | Month 7 |
| Fully Self-Funding From | Month 8 |
A payback period below 12 months is highly attractive for industrial environments with significant downtime exposure. In operations where downtime exceeds £10,000 per hour, well-scoped PdM deployments can often achieve payback within 4–8 months. For Apex Precision, the system becomes effectively self-funding from Month 8 onward.
Output 4: ROI Percentage
Formula: ((Annual Savings − Annual PdM Operating Cost) ÷ Total Investment) × 100
Calculation: ((£2,390,400 − £240,000) ÷ £1,350,000) × 100 = ~159%
| ROI Metric | Value |
|---|---|
| Annual Savings | £2,390,400 |
| Annual PdM Operating Cost | £240,000 |
| Total Investment | £1,350,000 |
| Year 1 ROI | ~159% |
| Year 3 Cumulative ROI | 387% |
Year 1 ROI is calculated using conservative downtime reduction assumptions. The model does not assume perfect prediction from day one. As the PdM system collects 12–18 months of operational data, model accuracy improves, false alerts reduce, and maintenance schedules become more precise. This creates a compounding effect where ROI improves further in years 2 and 3. The result is a stronger long-term business case: PdM begins as a downtime reduction program but matures into a data-driven asset performance improvement engine.
Output 5: Suggested Pilot Asset Priority
Not all 45 assets deserve equal priority in a PdM deployment. The pilot asset priority output scores each asset class across four dimensions to identify where the highest ROI per pound invested is achievable in the shortest timeframe.
| Asset Class | Downtime Impact | Failure Freq. | Sensor Readiness | Data Availability | Priority Score |
|---|---|---|---|---|---|
| Press Line A | Very High | High | Ready | Good | 9.2 / 10 |
| CNC Machining Centre (Group B) | High | Medium | Partial | Good | 7.8 / 10 |
| Hydraulic Power Units | High | High | Ready | Limited | 7.4 / 10 |
| Air Compressor Bank | Medium | Low | Ready | Excellent | 6.1 / 10 |
| Conveyor System | Low | Low | Partial | Limited | 3.8 / 10 |
Press Line A: Recommended Pilot Starting Point
Not every asset should be included in the first phase of a PdM deployment. The pilot priority model scores each asset class based on four key criteria:
- - 1. Downtime impact
- - 2. Failure frequency
- - 3. Sensor readiness
- - 4. Data availability
Press Line A scores highest because it combines three strong ROI indicators: very high downtime impact, high failure frequency, and existing sensor readiness. This makes it the fastest path to measurable results. A focused 90-day pilot on Press Line A can generate the internal evidence needed to justify the full 45-asset rollout.
For Apex Precision, the ROI model shows a clear investment case. The company is currently exposed to more than £6.2 million in annual downtime losses, while a properly scoped PdM deployment has the potential to recover approximately £2.39 million per year.
With a payback period of less than seven months and a Year 1 ROI of approximately 159%, predictive maintenance should be positioned not as a technology expense, but as a financial recovery and asset performance improvement program.
The recommended path is to begin with a 90-day pilot on Press Line A, validate the savings, and then scale the deployment across the wider 45-asset population.

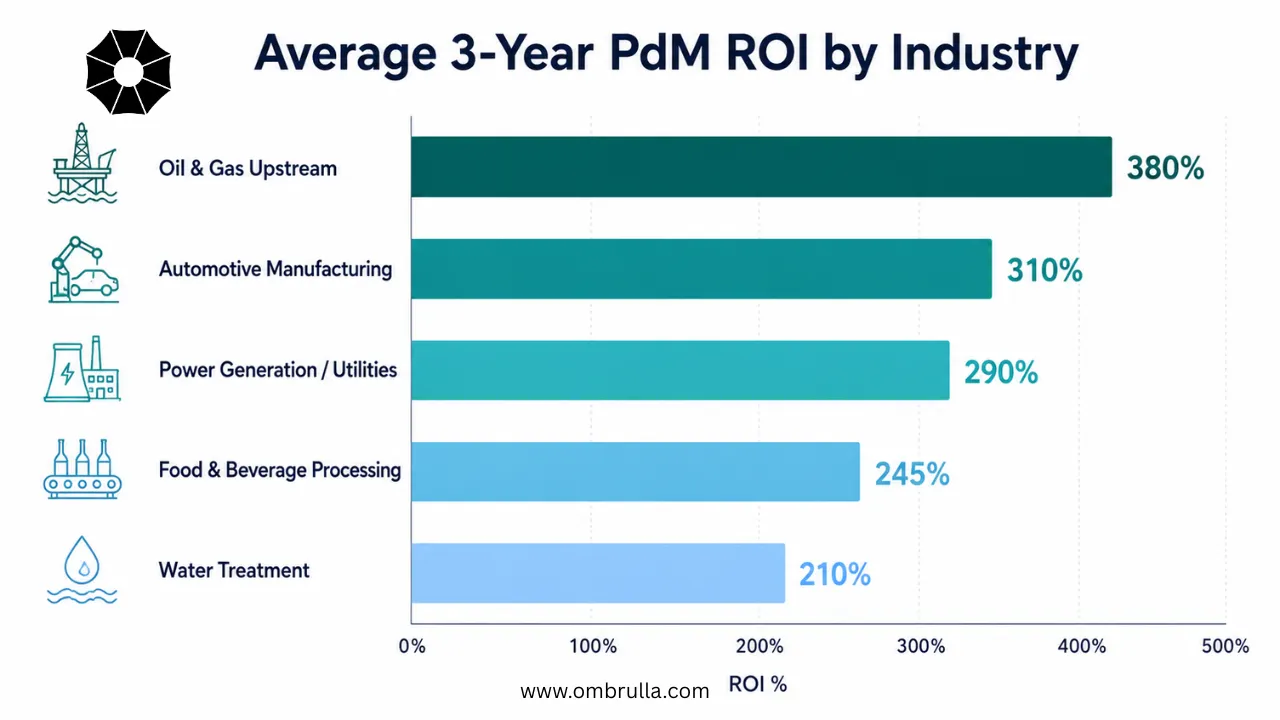

Industry Benchmark Data — What Good ROI Looks Like
Benchmarking your calculated ROI against industry peers is an important validation step — both for internal credibility and for pressure-testing your assumptions. The following benchmarks are drawn from published case studies, industry reports from Deloitte, McKinsey, ARC Advisory Group, and Frost & Sullivan, and practitioner experience across multiple sectors.

| Industry | Avg Downtime Cost/Hr | Typical Downtime Reduction | Avg Payback Period | 3-Year ROI Range | Key PdM Use Case |
|---|---|---|---|---|---|
| Oil & Gas Upstream | $150K–$500K | 40–55% | 3–6 months | 300–450% | Compressor, pump, rotating equipment |
| Automotive Manufacturing | £50K–£250K | 30–45% | 6–10 months | 250–380% | Press lines, welding robots, CNC |
| Power Generation / Utilities | $80K–$300K | 35–50% | 6–12 months | 220–340% | Turbines, generators, transformers |
| Food & Beverage Processing | £25K–£80K | 25–40% | 9–14 months | 180–280% | Fillers, packaging lines, refrigeration |
| Water Treatment | £15K–£60K | 25–35% | 10–18 months | 150–240% | Pumps, blowers, UV systems |
These benchmarks illustrate that even the most conservative sector — water treatment — typically delivers 150%+ ROI over three years. The key variable that shifts ROI most dramatically is the downtime cost per hour: the higher the production value of a stopped line, the faster the payback and the higher the total return.
Pilot Asset Priority: Which Machine Goes First?
One of the most practically valuable outputs of the ROI calculator is the pilot asset priority ranking. Choosing the wrong starting point for a PdM pilot is one of the most common reasons deployments underdeliver in their first year — either because the asset generates insufficient savings to be compelling, or because it lacks the sensor readiness and data quality to train a reliable model quickly.
The optimal pilot asset sits at the intersection of four criteria:
| Criterion | What It Means | Why It Matters for Pilot Success |
|---|---|---|
| High Downtime Impact | Each hour of failure costs significant money or production | Maximises savings visibility — makes ROI obvious and defensible to stakeholders |
| High Failure Frequency | Fails often enough for the AI model to learn from a meaningful event history | Faster model training and earlier confident predictions — essential for a short pilot window |
| Sensor Readiness | Existing vibration, temperature, pressure, or current sensors installed or easily installable | Avoids lengthy hardware installation lead times that delay pilot results |
| Historical Data Availability | At least 6–12 months of operational data, failure events, and maintenance records available | Enables retrospective model validation before go-live — building internal confidence |
The 3-Phase Pilot Design Principle
- - Phase 1 (Weeks 1–6): Deploy sensors, connect to platform, begin data ingestion and baseline anomaly detection. No AI predictions yet — purely observational.
- - Phase 2 (Weeks 7–14): Begin supervised model training using historical failure data. Generate first alert predictions in shadow mode — compare to actual outcomes without triggering work orders.
- - Phase 3 (Weeks 15–26): Go live with maintenance-integrated alerts. Maintenance team acts on AI predictions. Track: false positive rate, true positive rate, downtime avoided, and cost savings. Build the internal case study.
Financial Pitfalls: Protecting Your Business Case Credibility
An ROI calculation is only as reliable as its inputs. Errors in your model generally fall into two camps: Value Understatements (which kill viable projects in the boardroom) and Value Overstatements (which destroy professional credibility when actuals fall short).

Category 1: The Understatements (The Hidden Value You’re Missing)
Pitfall 1: Understating True Downtime Cost
- - The Error: Using only lost production revenue in the equation while forgetting idle labor, secondary equipment impact, penalty charges, and emergency response costs.
- - Financial Impact: Routinely understates true downtime costs by 30–60%, making the ROI calculation appear weak when the business case is actually strong.
- - Executive Fix: Build a comprehensive "cost stack" for downtime by working backward from impact. For a critical production line: (1) Calculate the marginal production revenue lost per hour, (2) Add fully-loaded labor costs for all personnel impacted (operators, supervisors, quality checkers standing idle), (3) Quantify secondary process delays and their cost, (4) Include any contractual penalties for missed delivery windows, (5) Factor emergency response premiums. Showing the true, fully loaded cost makes the business case significantly stronger and highly compelling to the board.
Pitfall 5: Neglecting the Asset Life Extension Value
- - The Error: Omitting long-term asset longevity from the business case because it is harder to quantify and realized further in the future.
- - Financial Impact: Leaves massive deferred CapEx off the table, missing out on an automatic 15–25% boost to total ROI.
- - Executive Fix: For capital-intensive assets with six- or seven-figure replacement costs, always include a conservative 10% life extension as a separate line item in your savings calculation. If OEM data suggests 20–30 year asset life, a 10% extension (2–3 additional years) is defensible and conservative. This single adjustment often adds $100k–$500k to your total three-year ROI, pushing a marginal business case into compelling territory.
Category 2: The Overstatements — The Blind Spots That Risk Credibility
Pitfall 2: Relying Uncritically on Vendor-Supplied Benchmarks
- - The Error: Treating vendor marketing case studies as guaranteed baseline realities. Vendor data represents flawless, best-case deployments under ideal conditions — not your operational environment.
- - The Risk: Applying a generic '400% ROI' claim without adjusting for your specific asset criticality, data quality, and organizational readiness is a direct path to missed targets and damaged stakeholder trust.
- - Executive Fix: Treat vendor figures as an absolute ceiling, not a starting baseline. For your business case: (1) Use vendor ROI as a reference, (2) Identify the specific operational conditions in the vendor case, (3) Score your environment against those conditions (asset data quality, team readiness, sensor accessibility), (4) Apply a downward adjustment factor of 0.6–0.8 to vendor metrics, (5) Build your business case on the adjusted figure. This conservative approach builds immediate credibility with finance stakeholders who will respect your analytical rigor.
Pitfall 3: Ignoring Non-Hardware Implementation Costs
- - The Error: Budgeting exclusively for sensor hardware and software licenses while ignoring the ecosystem required to run them.
- - The Cost Blind Spot: First-time buyers frequently underestimate non-hardware costs by 40–60%. A complete budget must include:
1. Edge compute & connectivity infrastructure
2. CMMS/ERP system integration
3. Data engineering, labeling, and model validation
4. Change management, staff training, and ongoing support
Pitfall 4: Assuming 100% of Modeled Savings Are Achievable
- - The Error: Assuming perfect execution where every single alert is caught, interpreted correctly, and actioned instantly by maintenance teams.
- - The Reality: No PdM system eliminates all failures. Sensor limitations, missed alerts, and organizational friction will always exist.
- - Executive Fix: Apply an "Operational Friction Discount" of 15–25% to your modeled savings. Presenting a discounted, highly defensible ROI figure builds immediate trust with finance stakeholders.
Making the Business Case: Presenting Predictive Maintenance ROI to the Board
Getting a Predictive Maintenance investment approved is not about explaining sensors, AI models, dashboards, or algorithms. It is about converting operational pain into boardroom language: financial return, business risk reduction, and strategic advantage.
For senior executives, PdM becomes compelling when it is positioned as a measurable business recovery program — not as a technology project.

The Boardroom Message
"We currently lose approximately £6.2 million per year due to unplanned downtime. Predictive Maintenance gives us a structured path to recover up to £2.4 million annually, with payback in under seven months and long-term benefits across reliability, sustainability, and operational resilience."
This opening immediately connects PdM to what the board cares about most: cash impact, risk control, and strategic value.
1. Lead with Financial Exposure, Not Technology
The strongest PdM business case starts with the cost of doing nothing.
- - Instead of saying: "We need sensors, AI models, and a predictive maintenance platform."
- - Say: "Unplanned equipment failures are currently creating a £6.2 million annual exposure through lost production, emergency repairs, spare parts escalation, overtime, and delayed customer commitments."
- - Then present PdM as a recovery mechanism: "By reducing downtime by 35%, we can recover approximately £2.39 million per year while improving asset availability and maintenance productivity."
This shifts the discussion from technical adoption to financial recovery.
2. Position PdM as an OpEx-Friendly Investment
Many boards hesitate when a project requires large upfront CapEx. Predictive Maintenance can be positioned more attractively when delivered through:
- - SaaS subscription models
- - Sensor-as-a-service options
- - Phased deployment by critical asset class
- - Monthly operating cost structure
- - Pilot-to-scale investment governance
This means PdM does not need to compete directly with major capital projects. Instead, it becomes a controlled operating investment that can begin generating savings early in the rollout.
Finance-facing message: "The investment can be structured as predictable monthly OpEx, with savings starting from reduced downtime, fewer emergency interventions, and better maintenance planning."
3. Present Risk-Adjusted ROI Scenarios
Boards do not want a single optimistic number. They want to see whether the investment still makes sense under conservative assumptions.
| Scenario | Downtime Reduction | Annual Savings | Payback Period | 3-Year ROI |
|---|---|---|---|---|
| Conservative | 25% | £1.72M | 9.4 months | 283% |
| Base Case | 35% | £2.39M | 6.8 months | 387% |
| Optimistic | 50% | £3.30M | 4.9 months | 524% |
Key Boardroom Takeaway: Even under the conservative scenario, the PdM investment pays back within the first year and delivers a strong three-year return. This builds confidence because the proposal is not dependent on perfect implementation or best-case assumptions.
4. Connect PdM to Strategic Priorities
A high-quality PdM business case should go beyond maintenance savings. It should connect directly to existing board-level priorities.
- - SustainabilityPredictive Maintenance improves energy efficiency by keeping assets operating within healthy performance ranges. It also reduces waste caused by premature part replacement and avoidable equipment damage.
- - ESGBetter maintenance planning reduces emergency logistics, unnecessary preventive work, excess spare usage, and avoidable production losses. This supports more responsible and efficient operations.
- - Digital TransformationPdM creates an IIoT and AI foundation that can later support quality analytics, energy optimisation, safety monitoring, asset lifecycle management, and autonomous operations.
- - Supply Chain ResilienceBy reducing unplanned production stoppages, PdM helps protect customer commitments, delivery SLAs, production schedules, and revenue continuity.
Board-Level Conclusion
Predictive Maintenance should be presented as a business performance initiative, not a maintenance technology upgrade.
The strongest board case is built around one clear message:
"PdM reduces financial leakage, protects production continuity, improves asset reliability, and supports our long-term digital and sustainability roadmap — with payback measured in months, not years."
When framed this way, Predictive Maintenance becomes easier for the board to approve because it speaks directly to financial return, operational risk, and strategic alignment.
Calculate Your PdM ROI — Right Now
Use our free interactive ROI calculator or book a tailored ROI assessment with our AI & IoT specialists.
What you get in a FREE 45-Minute PdM ROI Discovery Workshop:
- →A personalised ROI calculation using your actual asset data and downtime figures
- →Pilot asset priority ranking for your specific facility and asset mix
- →A board-ready one-page ROI summary document you can use immediately
Frequently Asked Questions
1. What is a realistic ROI for predictive maintenance in manufacturing?
A realistic first-year ROI for a well-implemented PdM programme in manufacturing ranges from 120% to 280%, scaling to 250–400% by year three as model accuracy improves. The most critical variable is downtime cost per hour: facilities where each hour of stoppage costs £50,000 or more typically see payback in under 9 months. Facilities with lower downtime costs may see payback in 12–18 months but still generate compelling long-term ROI through asset life extension and spare parts savings.
2. How do I calculate the true cost of industrial downtime?
True downtime cost = (Hourly production revenue x operating margin x production rate loss) + (Number of idled workers x hourly rate) + (Secondary equipment losses) + (Customer penalty charges) + (Emergency response premium). Most organisations that calculate this properly find their true downtime cost is 35–60% higher than their initial estimate. Use a bottom-up cost-build rather than a top-down estimate for the most credible figure.
3. How long does it take to see ROI from a predictive maintenance programme?
For high-downtime industrial environments, organisations typically see the first measurable cost avoidance event within the first 60–90 days of live monitoring — often a single predicted failure avoidance that pays for several months of platform subscription in one event. Full financial payback on the total investment typically occurs within 6–14 months for manufacturing and 3–7 months for oil & gas, where downtime costs are highest.
4. What percentage of downtime can predictive maintenance realistically eliminate?
In the first year of deployment, 25–40% downtime reduction is achievable for most industrial environments, rising to 45–65% by year three as AI models mature. The caveat is that not all failures are predictable: sudden catastrophic failures (electrical faults, operator errors, raw material defects) are outside PdM's detection scope. Realistic PdM programmes target detectable failure modes — typically 60–80% of an organisation's historical failure events.
5. Which assets should I prioritise for a predictive maintenance pilot?
Prioritise assets that score highly on four criteria: high downtime cost impact, high failure frequency, existing or easily deployable sensor infrastructure, and good historical data availability. Avoid starting with the most critical safety-system assets in the pilot phase — choose assets where a false alert or missed prediction is an inconvenience rather than a safety event. Build confidence in the technology with high-ROI, medium-criticality assets before expanding to safety-critical systems.
6. What data do I need before starting a predictive maintenance programme?
At minimum, you need: asset nameplate data (rated speed, power, temperature ranges), 12+ months of CMMS work order history including failure descriptions and downtime durations, existing sensor data streams if available, and process historian data if applicable. The AI model also improves significantly with: failure mode documentation from experienced maintenance engineers, OEM maintenance manuals with specification tolerances, and any existing condition monitoring records (manual vibration readings, oil analysis reports).
7. How does predictive maintenance differ from condition-based monitoring?
Condition-based monitoring (CBM) triggers maintenance actions when a sensor reading crosses a predefined threshold — for example, acting when vibration exceeds 7mm/s. Predictive maintenance uses AI/ML models to analyse patterns across multiple sensor inputs, time-series trends, and operational context to forecast when a failure will occur and with what probability. PdM typically provides 48–168 hours of advance warning versus the hours or minutes that CBM threshold alerts provide, enabling far better maintenance scheduling and spare part pre-positioning.
8. Can small and medium-sized manufacturers justify predictive maintenance investment?
Absolutely — particularly with the emergence of SaaS-based PdM platforms that eliminate large upfront CapEx and modern wireless IIoT sensors at dramatically lower cost than legacy condition monitoring hardware. An SME with 10–20 critical machines and downtime costs of £5,000–£15,000 per hour can typically justify a PdM investment with a 12–18 month payback and 150–250% three-year ROI. The key is scoping the deployment to the highest-criticality assets rather than attempting full-fleet coverage in the first year.
